Back to home page

LATEST UPDATES

We are updating this page with the latest information and key milestones as our work to build Stratford46 Business Park progresses.

Our primary aim is minimising disruption and we want to work closely with the community and key local stakeholders to make sure that everyone is kept updated and informed throughout.

Construction started in September 2025 and to date has involved completing the new access roundabout on the A46, building internal road infrastructure and work to survey, connect and divert utilities.

Our work to deliver on site infrastructure including earthworks, landscaping and the new internal access roads will continue into 2027. Construction of the first buildings is anticipated to start in 2028. We are also proposing to develop a nature reserve site as part of the overall scheme on 17-acres of adjoining land.

We will continue to minimise any disturbance caused to our neighbours and would like to reiterate our sincere thanks to the local community for their ongoing patience and cooperation.

Thumbnail 1
Indicative CGI aerial view (may be subject to change)

Indicative timeline of key activities

Activity Approx. start Approx. end
New Access Roundabout Summer 2025 Late 2026
STW water diversion July 2026 Late 2026
On site infrastructure works Spring 2027 Early 2028
Utility connections Late 2026 Late 2027
Construction of first building(s) 2028 TBC

Latest news

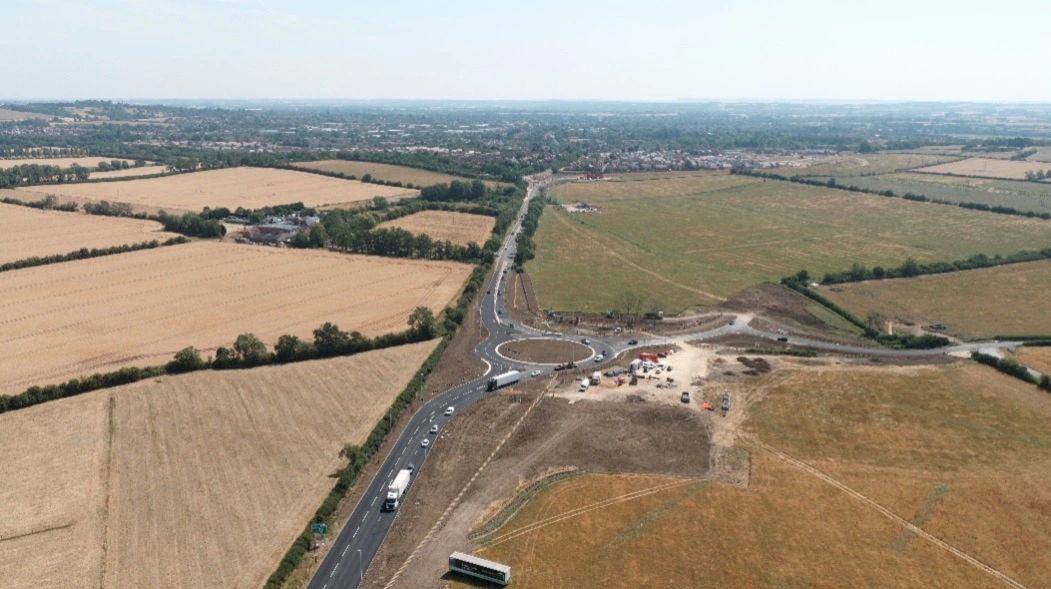

Completion of new access roundabout marks important milestone for Stratford46 Business Park

Completion of new access roundabout marks important milestone for Stratford46 Business Park

An important milestone at Stratford46 Business Park has been reached with the recent completion of the roundabout entrance to the scheme, part of a wider package of supporting infrastructure being delivered by IM Properties which is scheduled to be completed at the end of 2027.

Read more

Severn Trent Water main diversion

Between early July and November 2026 Severn Trent Water’s appointed contractor Avove Utilities will be carrying out work to divert the twin main water supply that runs through the Stratford46 Business Park site in preparation for the infrastructure works that will take place in 2027.

Read more
Launch of Stratford46 Community Fund – November 2025

Launch of Stratford46 Community Fund – November 2025

We are pleased to announce the launch of the Stratford 46 Community Fund which we have established in partnership with the Heart of England Community Foundation to support local charities and community groups surrounding Stratford46 Business Park.

Read more

Submission of minor planning applications – October 2025

Construction at Stratford46 Business Park continues to progress well and work to date has involved setting up our site compound and undertaking a programme of surveys along the A46, which has required the use of temporary overnight traffic management to allow our teams to work safely.

Read more

Overnight lane closures on the A46

One of our first activities from Summer 2025 has been conducting overnight surveys alongside the A46, which has required the use of temporary traffic lights and lane closures overnight to enable work to take place safely while keeping the road open.

Read more

Start of construction – September 2025

Construction work for the new access roundabout is now underway and we are committed to delivering this work with minimal disruption or delay.

Read more

Keeping in touch

We remain committed to keeping the community updated as the construction progresses and to give you advance notice of key activities such as any future road closures. Minimising disruption is our primary aim while we deliver Stratford46 Business Park.

To stay up to date on the very latest progress at Stratford46 Business Park, please register for updates here.
